Most website redesigns take 8 to 16 weeks, but the real number depends on factors most agencies never explain upfront. We walk through every phase, what slows projects down, and give you a free template to plan your own timeline.
Wondering how long your website redesign will actually take? Here's the honest answer.

If you've typed "website redesign timeline" into Google, chances are you're not looking for a lecture on design theory. You want a straight answer: how long is this actually going to take?
Fair question. And an honest one deserves an honest answer instead of a vague "it depends" that agencies love to hide behind.
So here it is. A typical website redesign takes anywhere from 8 to 16 weeks, depending on the size of your site, how much content needs rewriting, and how quickly your team can review and approve work. Enterprise projects with multiple stakeholders can stretch to 6 months or more. A simple, template-based refresh can be done in 3 to 4 weeks.
That's the short version. The rest of this guide breaks down exactly where that time goes, what slows most projects down, and how to build your own timeline so you're not left guessing halfway through. If you want the full step-by-step redesign process behind these phases, we cover that separately.
TL;DR
A standard business website redesign takes 8 to 16 weeks from kickoff to launch.
Small business or template-based redesigns can be done in 3 to 6 weeks.
Enterprise or SaaS platform redesigns typically run 4 to 6 months, sometimes longer.
The single biggest cause of delay isn't design or development. It's slow client feedback and missing content.
A realistic timeline has 7 phases: discovery, strategy, content, design, development, QA, and launch.
You can build a simple timeline template yourself using the framework below, no fancy software required.
Why "It Depends" Is Actually True (And What It Depends On)
Every agency blog says a redesign "depends on scope." That's not a cop-out, it's genuinely how project timelines work. But it's not helpful unless you know what specifically drives the number up or down.
Here's what actually moves the needle on your timeline:
Number of pages. A 5-page brochure site and a 60-page enterprise site are not the same project, even if the "redesign" label is the same.
Whether content is ready. Redesigns that wait on new copy, photography, or product data almost always run long. This is the number one delay we see at Groto, and it's rarely talked about upfront.
Number of decision-makers. One founder approving designs moves fast. A committee of eight stakeholders across three departments does not.
Custom functionality. A calculator, a booking system, a membership portal, or an integration with your CRM all add real development time, not just a few extra days.
Whether you're rebuilding on a new platform. Migrating from WordPress to a headless CMS or a new framework adds technical work that a simple visual refresh doesn't need.
Keep these five factors in mind as you read the phase breakdown below. They're the reason two "8-week redesigns" can end up taking wildly different amounts of time in practice.

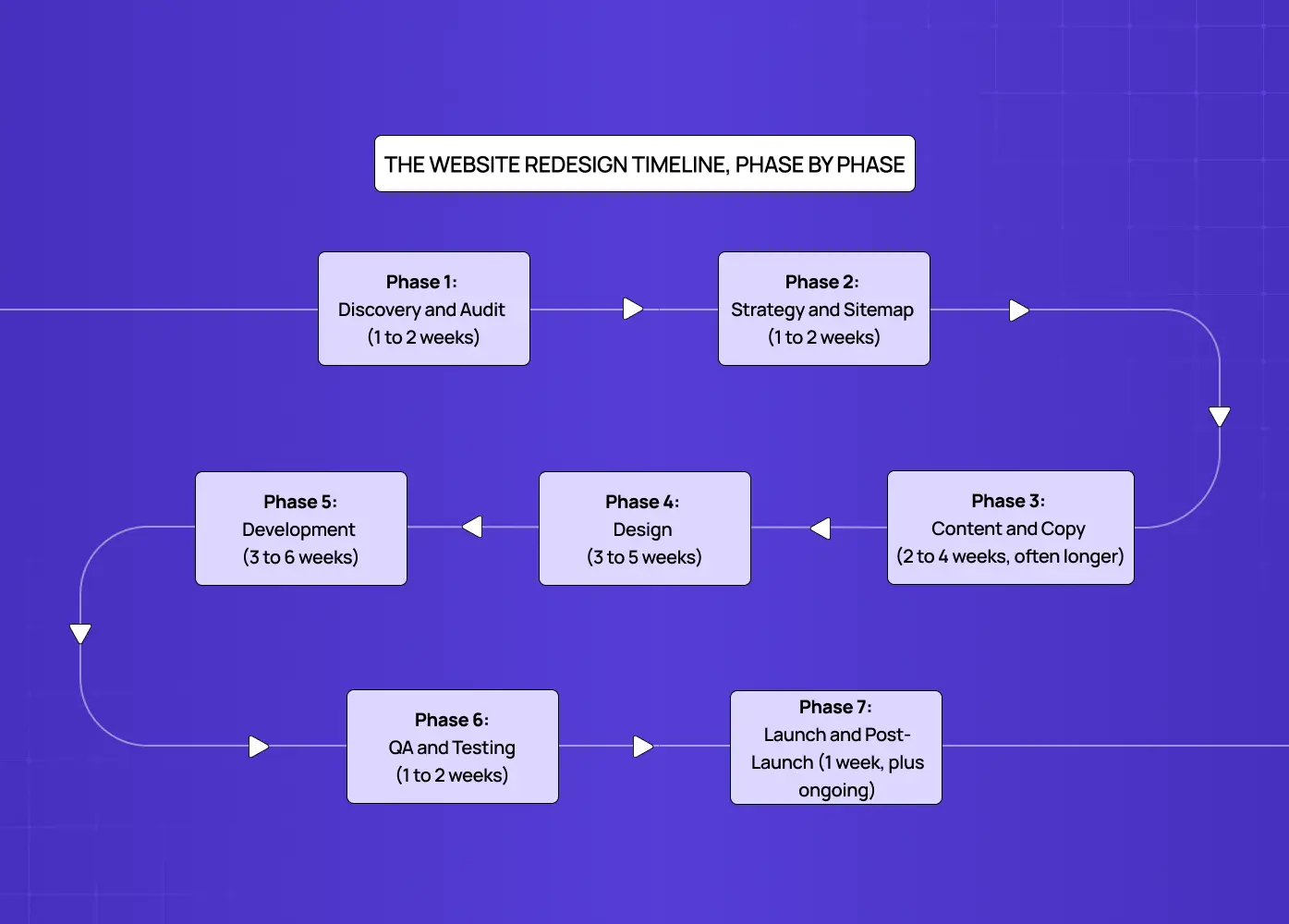

The Website Redesign Timeline, Phase by Phase

Most professional redesigns follow the same core sequence, rooted in a proven UX design process, even if agencies label the phases differently. Here's what typically happens, and how long each stage realistically takes.
1. Discovery and Audit (1 to 2 weeks)
This is where your team and your design partner get aligned on what's actually broken. If you want a head start before this phase even begins, you can self-audit your website first. A good discovery phase typically covers:
Analytics review to see where users drop off or bounce
User behavior analysis (heatmaps, session recordings, on-site search data) to surface bad UX patterns hurting conversions
Page speed and technical performance checks
An audit of existing brand assets and design patterns worth keeping
Stakeholder interviews to align on business goals and success metrics
Skipping or rushing this phase is how projects end up redesigning the wrong things. If your bounce rate problem is actually a page speed problem, no amount of new design will fix it.
2. Strategy and Sitemap (1 to 2 weeks)
Once you know what's broken, you map out what the new site needs to do, starting with your overall website structure. This phase usually produces:
A new sitemap showing how pages connect and how users navigate between them
Information architecture decisions, like what belongs in navigation versus footer links
A defined primary goal for each key page (lead form fill, purchase, demo request, and so on)
Early agreement on what content needs to be created versus what can be reused
This phase runs in parallel with content planning at most agencies, including us, since the sitemap and the content strategy inform each other.
3. Content and Copy (2 to 4 weeks, often longer)
Here's the phase most timelines quietly gloss over, and it's the one that derails more projects than any design or development delay combined.
If you're writing new copy, sourcing new photography, or restructuring your product information, this takes real time. This phase typically includes:
Drafting and approving copy for every key page, not just the homepage
Sourcing or shooting new photography and graphics
Gathering product data, pricing, or technical specs from internal teams
Writing SEO metadata and updating URL structures for existing content
Reddit threads on web design projects are full of people frustrated that their "8-week redesign" is in month four, and content is almost always the reason why. Our advice: start content work as early as possible, ideally alongside discovery, not after design begins.
4. Design (3 to 5 weeks)
Design typically moves through a few distinct stages:
Low-fidelity wireframes to lock in layout and hierarchy before visual style is added
Moodboards or style directions, often pulled from the best website design examples, to align on look and feel
High-fidelity designs for the homepage, guided by proven homepage design principles, and one or two key inner pages first
Sign-off on that initial system, then design applied across the rest of the site
Design timelines expand fastest when feedback rounds drag. A same-day turnaround on feedback keeps this phase on track. A two-week gap between review rounds can add a month to your project without anyone intending it to.
5. Development (3 to 6 weeks)
Once designs are approved, developers build the site, whether that's on WordPress, Webflow, Framer, a headless CMS, or fully custom code. This phase generally covers:
Responsive builds across desktop, tablet, and mobile breakpoints
CMS setup so your team can update content without a developer
Third-party integrations (CRM, email marketing, analytics, booking tools)
Any custom functionality, like calculators, dashboards, or membership areas
Complex functionality is where estimates go sideways most often. A standard content page takes hours. A custom interactive tool, like the cost calculator we built for Meydan, takes considerably longer and should be scoped separately from the rest of the site build.
6. QA and Testing (1 to 2 weeks)
Before launch, the site gets tested across browsers, devices, and screen sizes. A thorough QA pass usually checks:
Every form, from contact forms to checkout flows
Internal and external links for broken or outdated URLs
Page speed and Core Web Vitals scores
Accessibility basics like alt text, contrast, and keyboard navigation
301 redirects mapped from every old URL to its new equivalent
This phase is easy to compress under deadline pressure, and it's the one that comes back to bite teams post-launch in the form of broken forms or missing redirects that tank organic traffic.
7. Launch and Post-Launch (1 week, plus ongoing)
Launch day itself is usually quick if QA was thorough. What matters more is the week or two after launch, which typically includes:
Monitoring analytics for traffic drops or unexpected behavior changes
Watching Search Console for crawl errors or indexing issues
Checking for 404s from old URLs that redirects might have missed
Fixing anything real users run into that testing didn't catch
Website Redesign Timeline by Project Size
Here's how these phases typically add up depending on the scope of your project.
Project Type | Typical Timeline | Best For |
Template-based refresh (Squarespace, Framer, Webflow templates) | 3 to 6 weeks | Small businesses, portfolios, simple service sites |
Standard business website redesign | 8 to 16 weeks | Most B2B companies, small to mid-size SaaS, ecommerce brands |
Complex or custom platform redesign | 4 to 6 months | Enterprise sites, platforms with custom functionality, multi-stakeholder approvals |
Full product or SaaS platform redesign | 4 to 8 months | SaaS companies rebuilding core user experience alongside marketing site |
If you're wondering where your project lands, ask yourself these three questions:
How many pages am I actually redesigning?
Is my content ready, or does it still need to be written and gathered?
How many people need to sign off on each decision?
Those three answers will tell you more than any generic timeline chart, and if budget is your other big question, we break down exactly how much a redesign costs in a separate guide.

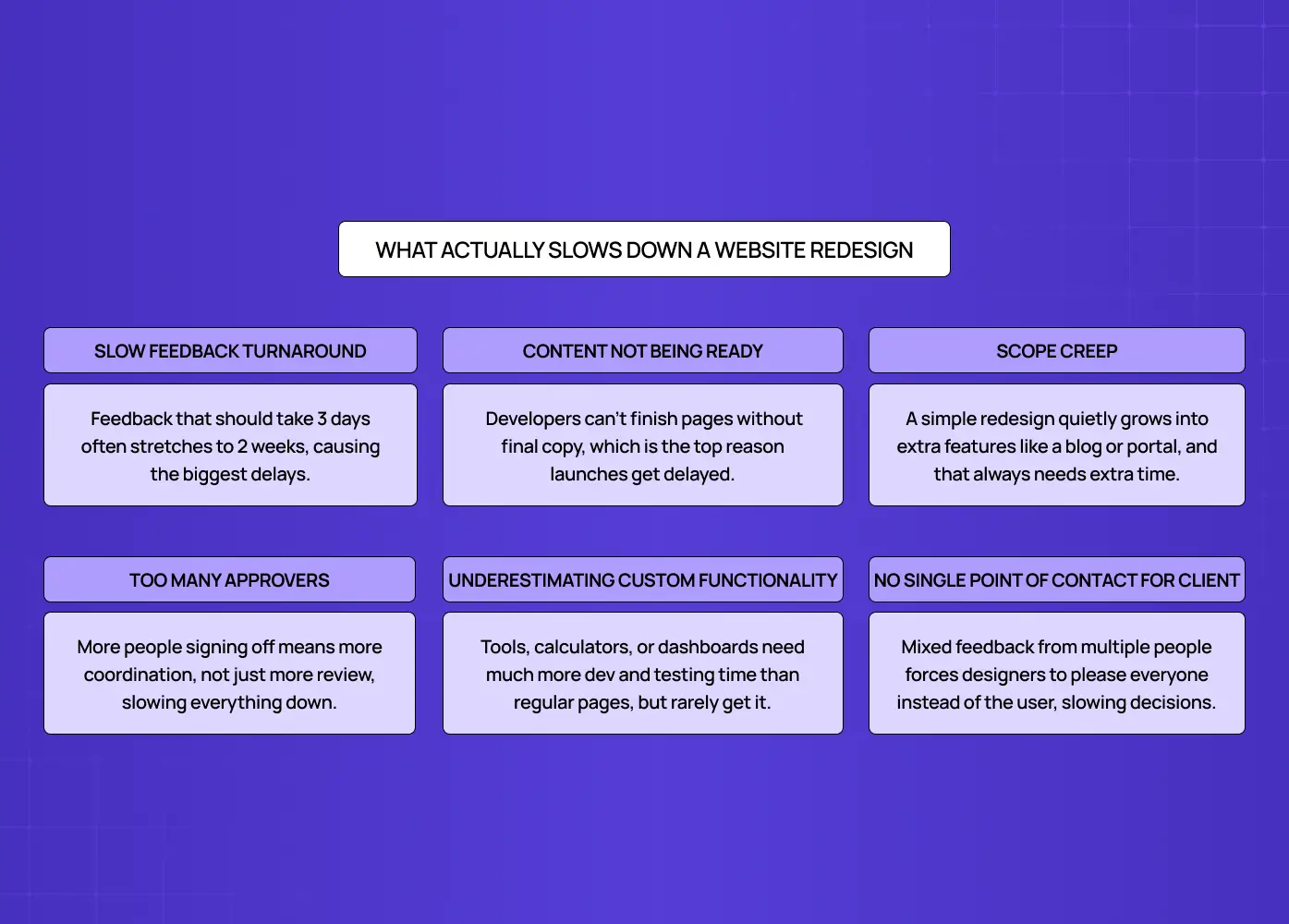

What Actually Slows Down a Website Redesign

If you've been through a redesign before, or you're reading Reddit threads from people who have, you already know the phase-by-phase breakdown above is the easy part to predict. What's harder to predict is everything that happens between the phases.
Here's what consistently pushes timelines past their original estimate:
Slow feedback turnaround. A design phase built for 2 rounds of feedback with 3-day turnarounds can quietly become 5 rounds with 2-week gaps. This alone accounts for more timeline overruns than any other single factor.
Content not being ready. Development can't finish building pages that don't have final copy. Waiting on content is the most common reason "final" launch dates slip.
Scope creep. A redesign that starts as "update the design" becomes "also let's add a blog, a resource center, and a client portal" halfway through. New scope needs new time, even when the request feels small.
Too many approvers. Every additional person who needs to sign off adds coordination time, not just review time. A single decision-maker can approve a homepage in a day. A committee can take two weeks to agree on a button color.
Underestimating custom functionality. Interactive tools, calculators, dashboards, or integrations are frequently scoped like static pages when they need dedicated development and testing time.
No single point of contact on the client side. When feedback comes from five different people with five different opinions, designers end up building for consensus instead of building for users, and that takes longer.
The good news is that every one of these is preventable with the right planning upfront, which is exactly what the template below is for.
A Simple Website Redesign Timeline Template
You don't need expensive project management software to plan a redesign. A basic table like this, built in a spreadsheet or even a shared doc, covers what most teams actually need.
Week | Phase | What Should Be Done |
1-2 | Discovery & Audit | Current site audit, stakeholder interviews, goals defined |
3-4 | Strategy & Sitemap | New sitemap approved, content plan started |
3-6 | Content & Copy | Draft copy for key pages, photography or assets gathered |
5-8 | Design | Wireframes, then high-fidelity design for key templates |
8-12 | Development | Site built, CMS set up, integrations connected |
12-13 | QA & Testing | Cross-browser and device testing, redirect mapping |
13-14 | Launch | Go live, monitor analytics and fix issues |
To adapt this template to your own project:
Copy the structure into a spreadsheet or shared doc
Adjust the week numbers based on your project size from the table above
Assign a named owner to each row instead of a vague "team"
Add a status column so everyone can see what's on track versus at risk
Review it weekly, not just at the start of the project
That single change, having a named owner per phase, is one of the simplest ways to keep a project on schedule.
If you want this built out further with task-level detail, we've got downloadable planning resources on our free resources page that go deeper than a basic template.

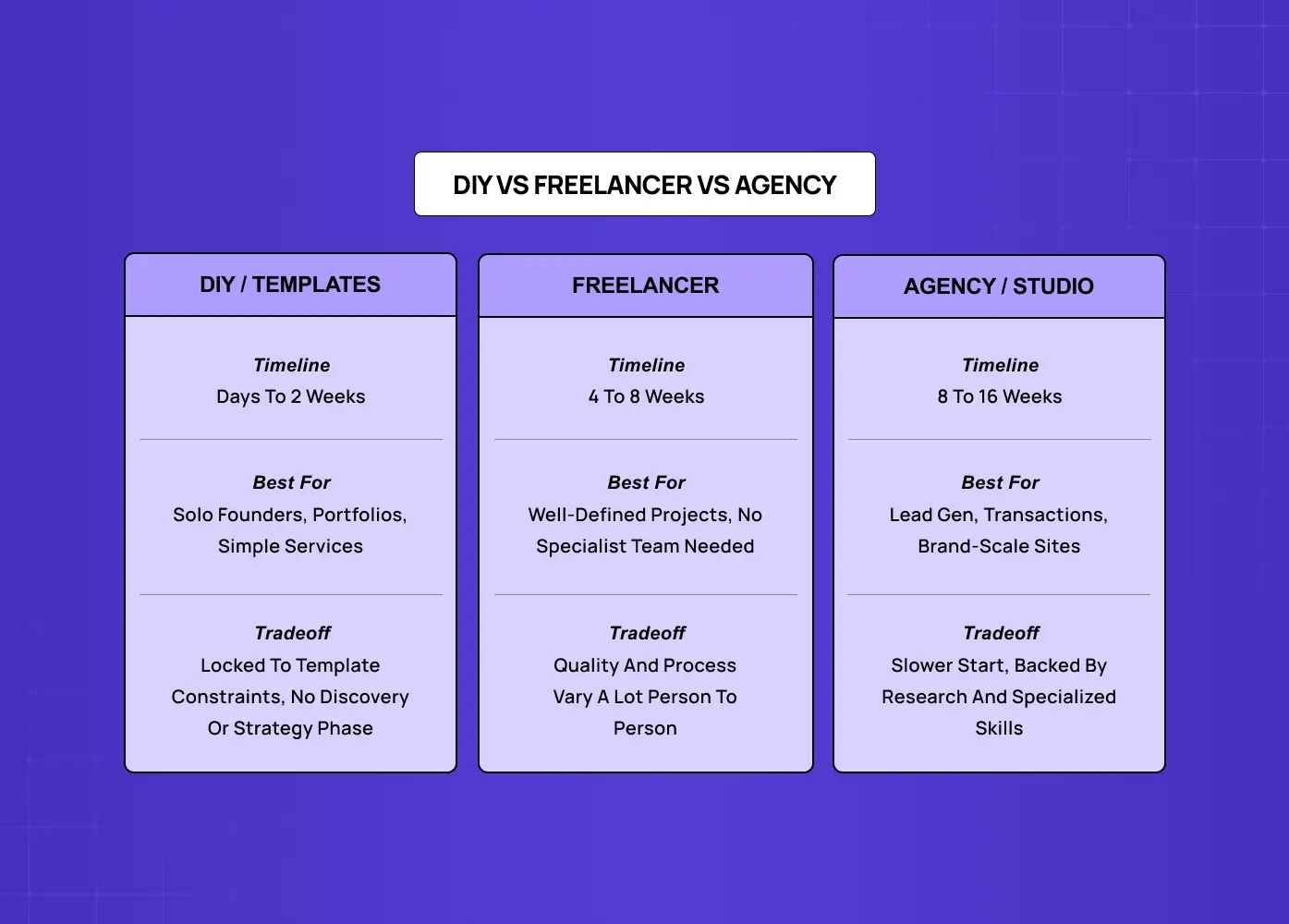

DIY vs Freelancer vs Agency: How the Timeline Changes

A lot of the searches around this topic, including questions like "can I make a website in 2 days," come from people trying to figure out if there's a faster path than the multi-month process described above. There is, but it comes with real tradeoffs.
DIY or template builders (Squarespace, Wix, Framer templates)
Timeline: a few days to 2 weeks for a basic site
Best for: solo founders, portfolios, simple service businesses
Tradeoff: you're working within a template's constraints, with no discovery or strategy phase informing your design decisions
Working with a freelancer
Timeline: typically 4 to 8 weeks
Best for: well-defined projects that don't need a full team of specialists
Tradeoff: quality and process consistency vary significantly from freelancer to freelancer
Working with an agency or studio
Timeline: typically 8 to 16 weeks for a standard project
Best for: sites doing real business work, generating leads, processing transactions, or representing a brand at scale, just make sure you're choosing the right web design agency for the job
Tradeoff: slower to start and a bigger investment, so it's worth understanding web design agency pricing upfront, but you're backed by research, strategy, and a team with specialized skills across UX, design, and development
There's no universally correct answer here. A landing page for a weekend event doesn't need a 12-week process. A SaaS platform's marketing site probably does, especially if you're already seeing the signs your SaaS site needs a redesign.
How Groto Approaches a Website Redesign
Rather than talk in the abstract, it's worth looking at what a realistic redesign process looks like in practice.
When Meydan FZ came to us, the goal wasn't just a visual refresh. Their site needed to guide entrepreneurs setting up in Dubai's free zone through a genuinely complex decision process. That meant building a custom cost calculator and streamlining the UX around compliance information, work that went well beyond a template swap and required real discovery and strategy time before design even started.
Similarly, our work with PolicyBazaar focused on reducing drop-offs across the insurance shopping journey. That kind of outcome doesn't come from a fast visual update. It comes from understanding where users were getting stuck first, and from knowing when to redesign your SaaS UX in the first place, which is exactly why the discovery and strategy phases matter as much as they do in the timeline above.
Both projects reinforce the same point made throughout this guide:
Timelines stretch or compress based on strategic and content work, not just page count
Custom functionality needs to be scoped and timed separately from standard pages
Discovery and strategy phases pay off most on projects solving a specific user problem, not just refreshing a look
How to Keep Your Redesign on Schedule
A few practical habits make a bigger difference to your timeline than almost anything else:
Assign one person as the single point of feedback on your side, even if multiple people are involved in reviewing.
Start content work in week one, not after design is finished.
Set feedback turnaround expectations upfront, ideally 2 to 3 business days per round.
Scope custom functionality separately from standard page design and development.
Build in a buffer week before launch for QA, redirects, and last-minute fixes.
Agree on what "done" looks like for each phase before that phase begins.
None of these require extra budget. They just require deciding on them before the project starts instead of figuring them out reactively.
Conclusion
A typical website redesign takes 8 to 16 weeks for most businesses, with template-based projects finishing in 3 to 6 weeks and enterprise projects running 4 to 6 months or longer.
The 7 core phases are discovery, strategy, content, design, development, QA, and launch.
Content readiness and feedback turnaround affect your timeline more than design or development speed does.
Use the project size table and the simple timeline template above to build a realistic schedule for your specific project.
DIY and template builders can get you live faster, but agency-led redesigns make sense when strategy and custom functionality matter to your business outcomes.
The clearest way to protect your timeline is deciding on ownership, feedback speed, and scope before work begins, not after delays happen.
